Lot of consternation about this announcement.

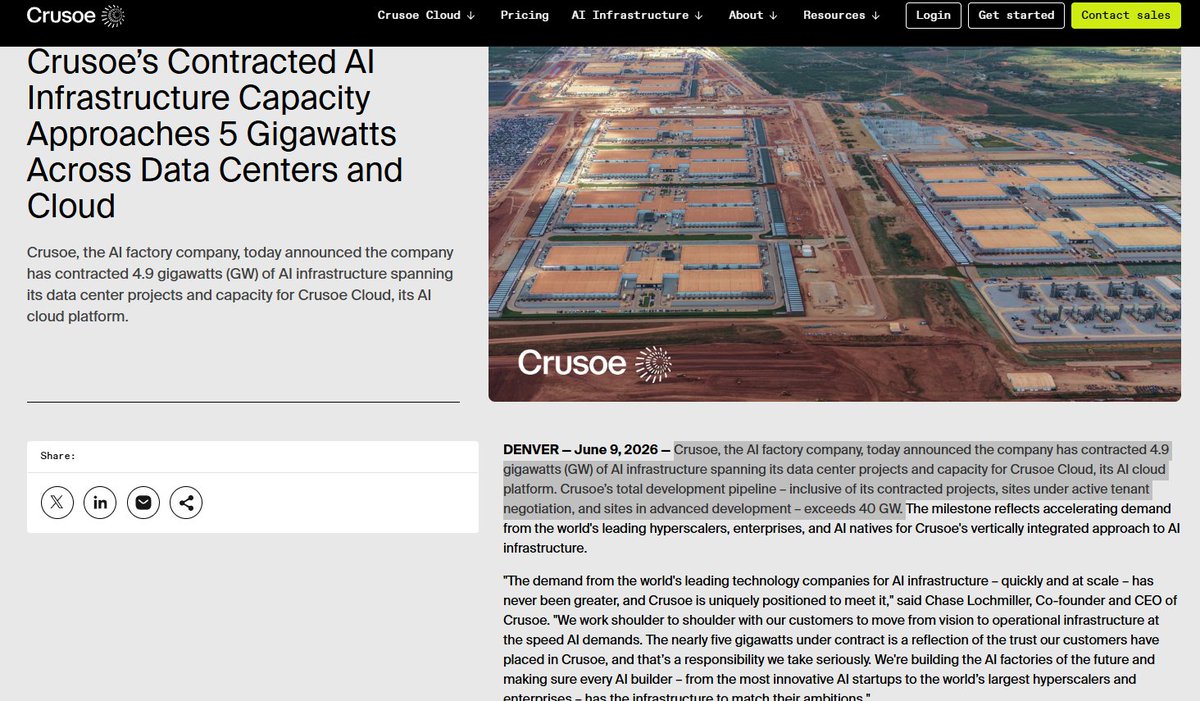

Crusoe’s June 9 release says it has 4.9 gigawatts of contracted AI infrastructure capacity across data center projects and Crusoe Cloud, against a 40 gigawatt total development pipeline. The contracted portfolio spans 5 US AI campuses: Abilene for Oracle, a second 900 megawatt Abilene campus for Microsoft, two additional large Texas campuses, and one in Missouri. Wyoming / Project Jade is not named in that contracted-campus list.

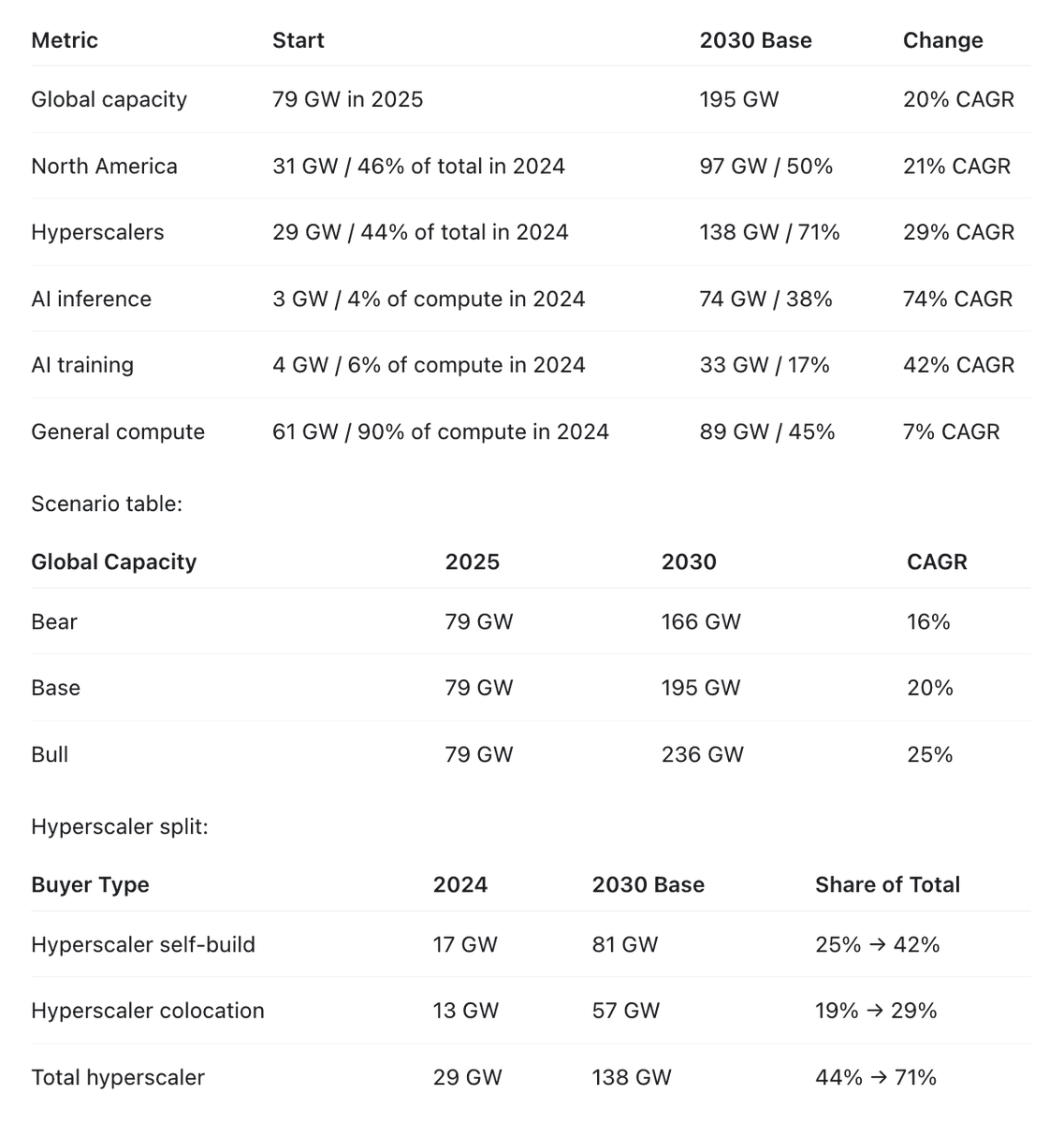

The original Wyoming plan was 900MW-1.8 GW in SE Wyoming scalable up to 10GW. Even assuming the most bearish read on impact (full capacity hit to contracted & pipe, that's still 3.1GW contracted and 30GW pipeline.
Assuming $10-$12M/MW, that represents $30-50B contracted and $300-400B pipeline of which Crusoe is going to take a fair share of. That math is not meant to imply Crusoe revenue dollar-for-dollar; it is a rough capex-sizing frame. But even haircutting the pipeline heavily, the scale remains meaningful.
The reporting is mixed. Third-party reporting says Crusoe has paused Project Jade at the customer’s request, while local reporting appears to have framed the situation more strongly as Crusoe having left the project. I would not treat “paused” and “exited” as economically equivalent until Crusoe, Tallgrass, AEP, Bloom, or the tenant clarifies. A pause can reflect cadence, customer timing, permitting, interconnection, equipment, financing, local opposition, or site prioritization; an exit would be a more material signal.
To be clear, this is a negative datapoint for Project Jade and potentially a timing / pipeline-conversion risk for Crusoe & Bloom, but I would not frame it as evidence that the AI infrastructure race is broadly slowing. More likely, it highlights that the bottleneck is not just raw megawatts but also customer cadence, siting, permitting, local acceptance, power architecture, and execution sequencing (as many of us have been saying for some time). Don't underestimate how unpopular AI and datacenters are becoming across the US.

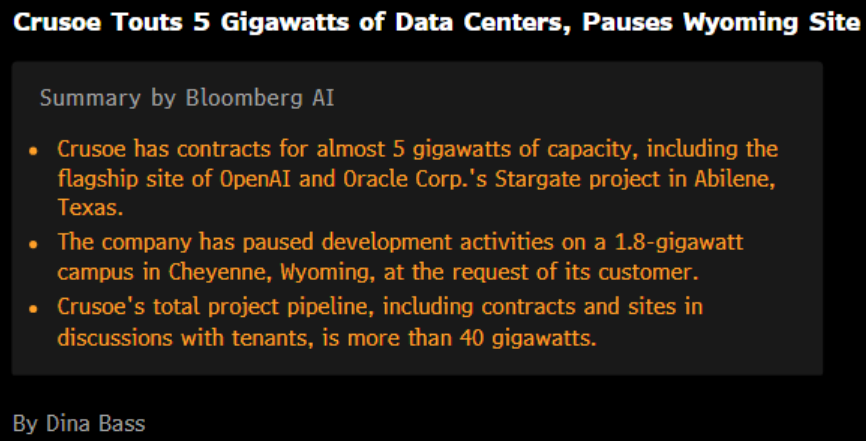

*DATA CENTER DEVELOPER CRUSOE PAUSES AI PROJECT IN WYOMING
Crusoe, a data center developer for hyperscalers, announced they’re pausing development activities of a 1.8GW campus in Wyoming at the request of its customer.
“Crusoe was working with Blackstone Inc.-backed energy company Tallgrass to develop a 1.8-gigawatt campus in Cheyenne, Wyoming, for an undisclosed tenant. “At the request of our customer, Crusoe has paused its development activities” on the site, the company said Tuesday in a statement.””
Customer likely a hyperscaler hitting the pause button. At least partially being attributed to tech dump
